Proposed : Mt Pleasant Rd. Bridge Replacement

LAST UPDATED:

May 29, 2025

Project Details

Communities:

Green

Project Contacts:

Project Manager: Ron Spano

Design Consultant:

Compass Infrastructure

Project Schedule

Plan Year:

01-01-2025 - 12-31-2025

Bid Due Date:

Apr 2, 2025

This project will be a complete replacement of the existing 40ft wider existing structure with a prestressed box beam bridge that includes a composite deck and triple steel tube railing. It is located just West of Camp Y-Noah in the City of Green.

Status:

Project was sent for bid and Kenmore Construction was awarded the contract.

  • 03/25/2025: Waiting on contract to be signed
  • 04/01/2025: Planning preconstruction meeting to be scheduled next week.
  • 04/15/2025: Held preconstruction meeting.  Detour will be in Stark County. Kenmore plans to start work end of July and will set beams in Aug, weather permitting.
  • 04/29/2025: Consultant has submitted precast concrete beam drawings for review and acceptance.
  • 05/06/2025: Revised beam plans have been submitted.  Waiting on review comments.
  • 05/13/2025: Comments were sent back to contractor.

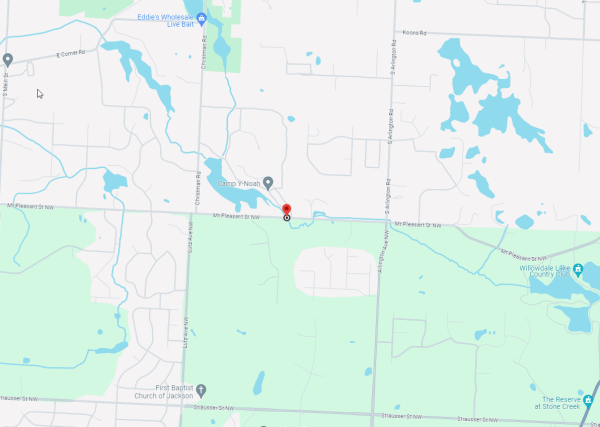

Graphical map of project site

Maintenance of Traffic:

To be determined in the design phase.

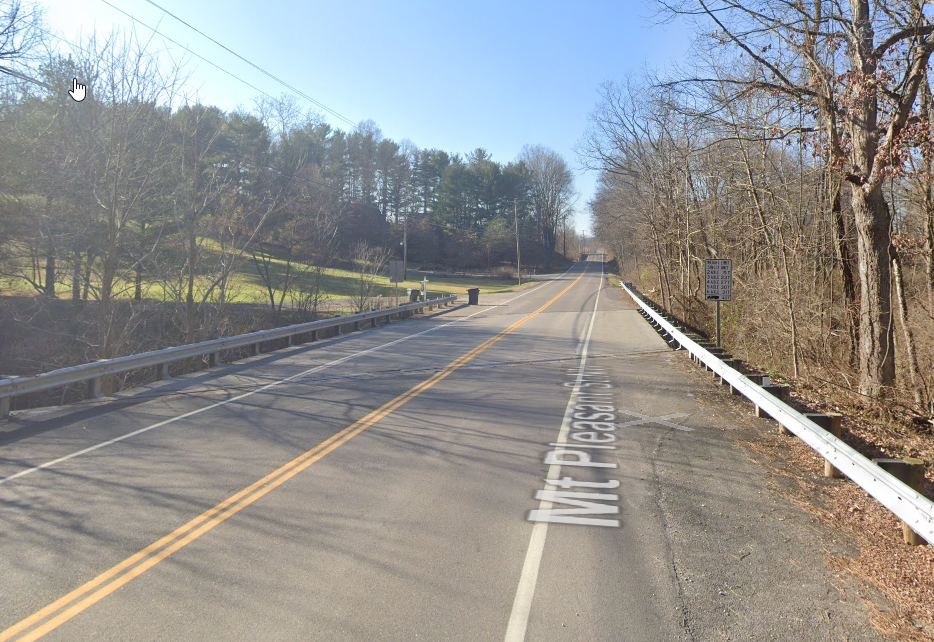

Image of Mt Pleasant Rd over Nimisila Creek POV

Costs

Total:

$737,822.00

Funding Sources:

To be determined.
